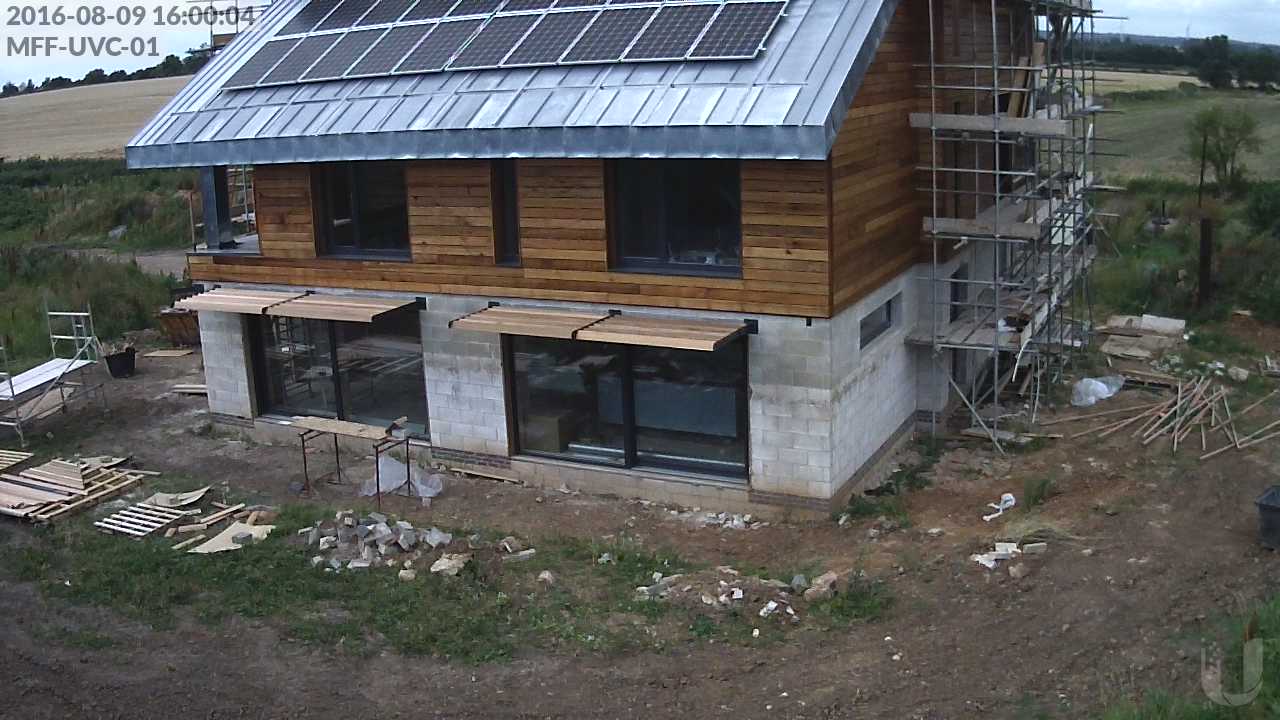

Week 43, Day 2

Week 43, Day 2:

  • Most of the solar shading is now installed, though not yet the tricky area where two sections are mitred together at the south-west corner
    • These will be oiled to match the cedar cladding
  • The zinc roofing is nearing completion, with just a small section of the main roof fascia to complete plus some other bits and pieces
  • More work on the timber cladding reveals and the aluminium window sills for the first- and second-floor windows
  • More work installing the internal doors, now all hung (albeit with no handles or latches) on the Second Floor
  • A bit of second-fix plumbing, fixing more of the shower rails and re-installing the underfloor heating manifolds
  • More oak flooring, this time in the Living Room
    • This is a larger area than e.g. the Dining Room and significantly complicated by the “floor boxes” which provide the option of power, data and lighting connections away from the walls, without trailing leads
    • Most floor boxes are intended for installation in offices where they are hidden under desks and don’t need to look great but Cableduct Limited manufacture a range of solutions which look rather better
    • I opted for 4 of their 700 series round service outlet box in stainless steel – once installed only the slim stainless steel circular rim and the outlet plate will visible
      • The “retro-fit” variant of the same box is installed in the polished concrete floor in the Open Plan area – 20mm oak planks will happily span across the square steel box around the circular opening but that would not work with concrete
      • With the “retro-fit” boxes a smaller, octagonal electrical box is entirely contained within the diameter of the round lid
  • A review of options for the stone cladding which will cover over the concrete blocks around the ground floor walls
    • This is proving problematic to source within budget and on reflection the architects should have allowed for a greater thickness of cladding (it was specified as 30mm plus mortar/adhesive) to accommodate a wider range of options
    • The type of stone isn’t under debate – it will be Buff Sandstone from one of the quarries in Derbyshire – mainly because that is the local stone in the area and was used for the foundations of the old farmhouse
    • One option is Stancliife Stones (part of Marshalls) who can supply Stanton Moor Buff Sandstone which is exactly the right sort of stone
    • Another option is one of the proprietary stone cladding suppliers but they don’t seem keen to provide samples
Week 43, Day 2

Week 43, Day 2

Closer view of the solar shading

Closer view of the solar shading

Zinc roofing mostly complete on the west-facing fascia

Zinc roofing mostly complete on the west-facing fascia

Engineered oak flooring partially completed in the Living Room

Engineered oak flooring partially completed in the Living Room

Close up of one of the floor boxes before the flooring is laid

Close up of one of the floor boxes before the flooring is laid



Week 43, Day 1

Week 43, Day 1:

  • Another failure of the automated blog posting logic, because the mains power was off for several hours on Sunday and I’d forgotten that the Raspberry Pi computer which is responsible for grabbing the hourly snapshots from the time-lapse camera loses time when the power is off, so it was taking snapshots but not labelling them with the correct time
  • Delivery of the MDF boards for the architraves and skirtings
  • Assembly of the solar shading panels ready for installation tomorrow
    • These arrived as separate cedar fins, brackets and fixings for assembly on-site
    • Cedar is notoriously bad at holding screw fixings into the end-grain so it is good to see the fins held in place with 12mm pins attached to the end-plates rather than screws into the cedar, and also to see a gap between the plates and the fins so they don’t rot at the ends
  • Installation of the first of the internal doors, which are pre-finished oak veneered fire doors from JB Kind doors in Swadlincote, South Derbyshire – specifically their Roma Diana model
    • These are nice looking, solid doors and are available in bespoke sizes at a reasonable price
    • They do some more traditional oak doors with raised panels or grooved detailing but those are only available in standard sizes – unless ordering in very large quantities
  • Installation of the engineered oak flooring in the Dining Room
  • Installation of the last of the zinc roofing on the main section of the north roof
    • Now just the edges and fascias to complete
Week 43, Day 1

Week 43, Day 1

Solar shading units partially assembled

Solar shading units partially assembled

Internal Door (to Plant Room)

Internal Door (to Plant Room)

Oak flooring in Dining Room

Oak flooring in Dining Room

Last section of zinc on main area of north roof

Last section of zinc on main area of north roof
