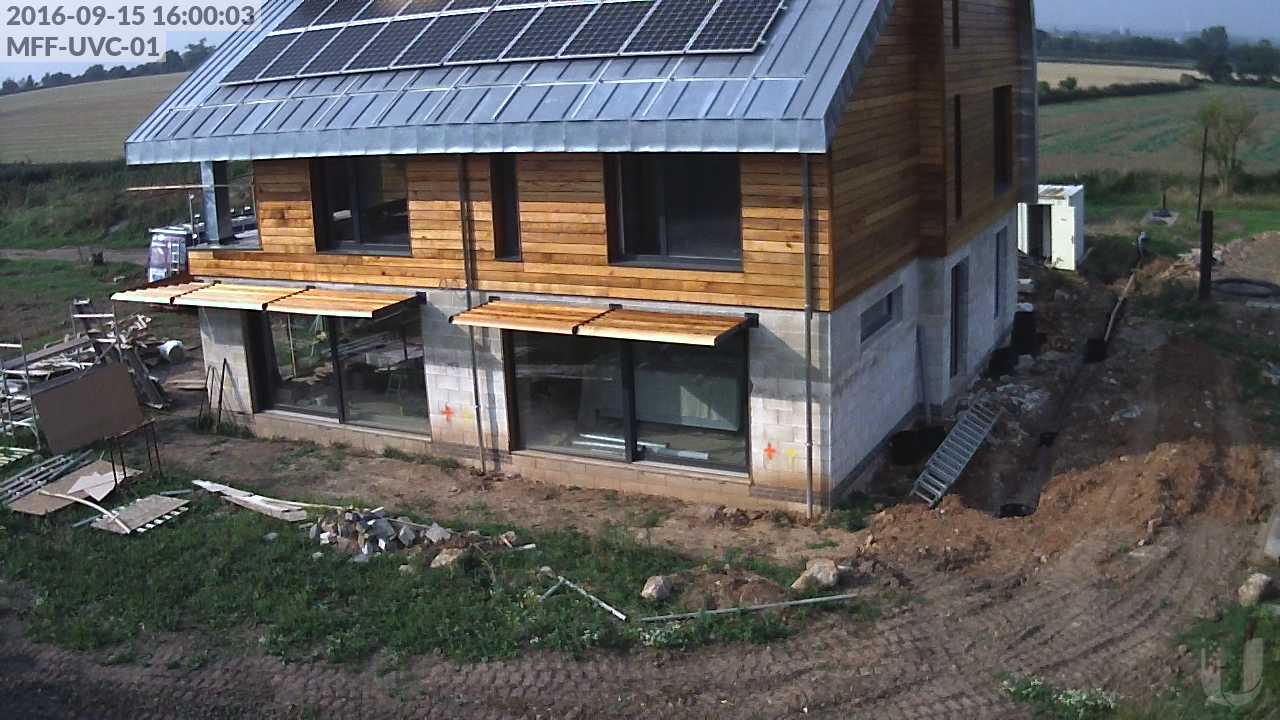

Week 48, Day 4

Week 48, Day 4:

  • The team from Alvaston Glass were on-site for most of the day making templates for the tempered glass balustrades on the staircases and the balcony
  • More second-fix electrical, with more installations in the Plant Room (notably the sub-meter for the Ground Source Heat Pump) and more LED drivers on the First Floor
Week 48, Day 4

Week 48, Day 4

Temporary wooden boxes over staircase treads in preparation for templating for the glass

Temporary wooden boxes over staircase treads in preparation for templating for the glass

More DALI-dimmable LED drivers for the First Floor

More DALI-dimmable LED drivers for the First Floor

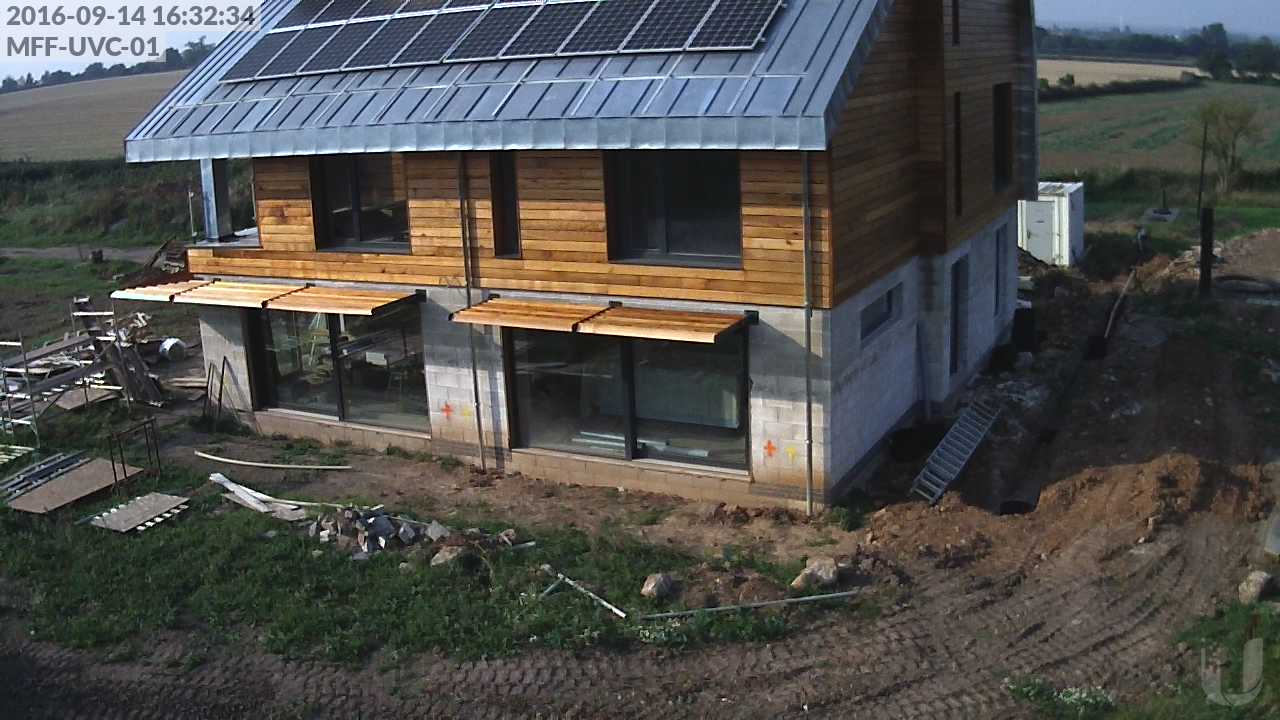

Week 48, Day 3

Week 48, Day 3:

  • Good progress on the balustrade for the balcony, installing the brackets for the handrail and the clamps for the glass panel
  • Some initial preparations for finishing off the staircase
  • Nearing completion with the plumbing for the Ground Source Heat Pump
  • More second-fix electrical, mainly working on the 230V DALI dimmers for the mains-voltage lighting circuits
Week 48, Day 3

Week 48, Day 3

Support posts and clips for the glass balustrade on the balcony

Support posts and clips for the glass balustrade on the balcony

230V DALI dimmers for the First Floor

230V DALI dimmers for the First Floor
