Week 76, Day 5

Week 76, Day 5:

  • Another air pressure test following the work on the window and door seals on Tuesday.
    • The build team were hoping the replacement of the sliding door seals in particular would make a big difference (despite having taped over those seals during some previous tests wth minimal impact) but I wasn’t expecting a huge improvement.
    • The test came in at 0.9 ACH @ 50 Pa whereas Passivhaus Certification demands 0.6 or lower, so still more work to do.
  • Good progress on the 50m-long swale that will take the rainwater from the house roof and attempt to disperse it before allowing any excess to drain to the field ditch through a controlled outflow
  • More minor internal snagging items completed, including re-instating the end caps on the lower flight of stair treads
Week 76, Day 5

Week 76, Day 5

Partially completed swale to the west of the house

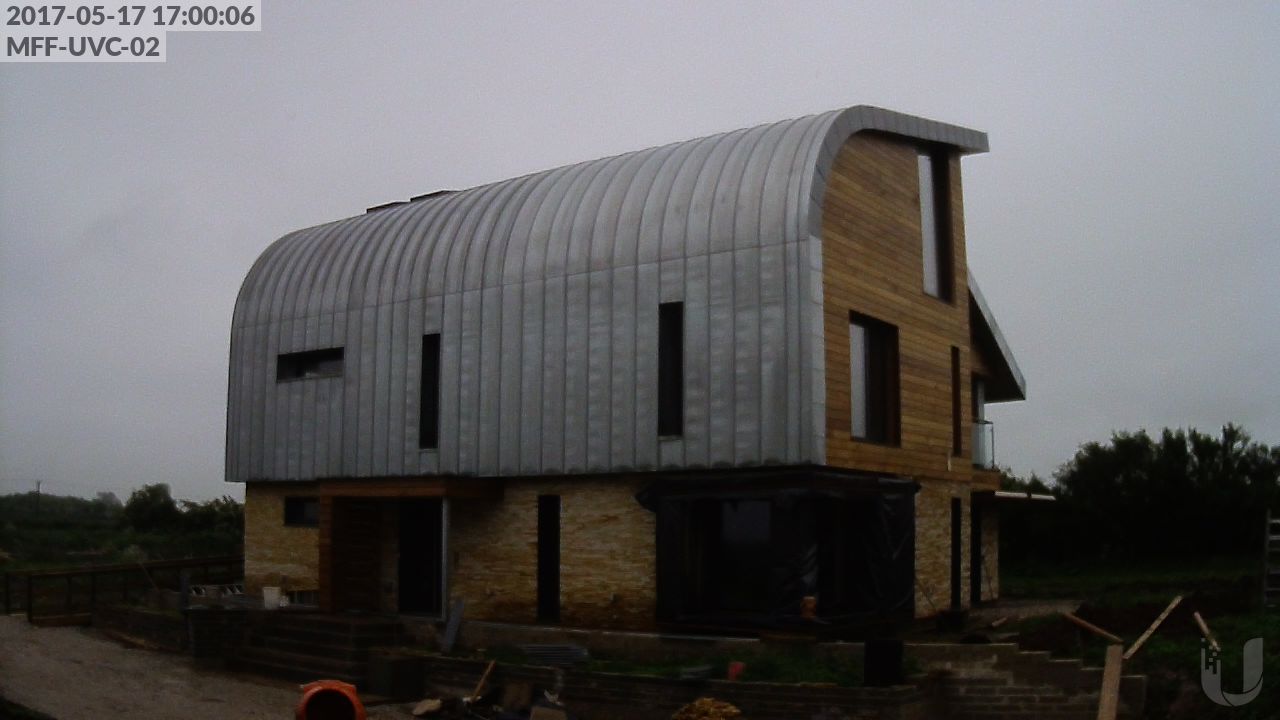

Week 76, Day 3

Week 76, Day 3:

  • Further progress with internal snagging – most notably tightening the fixings for the stair treads
  • Fitting the cover plates on the junction boxes for the external lights
Week 76, Day 3

Week 76, Day 3
