Outbuildings: Week 28, Day 2

Outbuildings: Week 28, Day 2

Completion of the installation of the main set of windows and doors and also the installation of the ridge tiles on the roof over the Garages (taking advantage of a day of dry and not particularly windy weather).

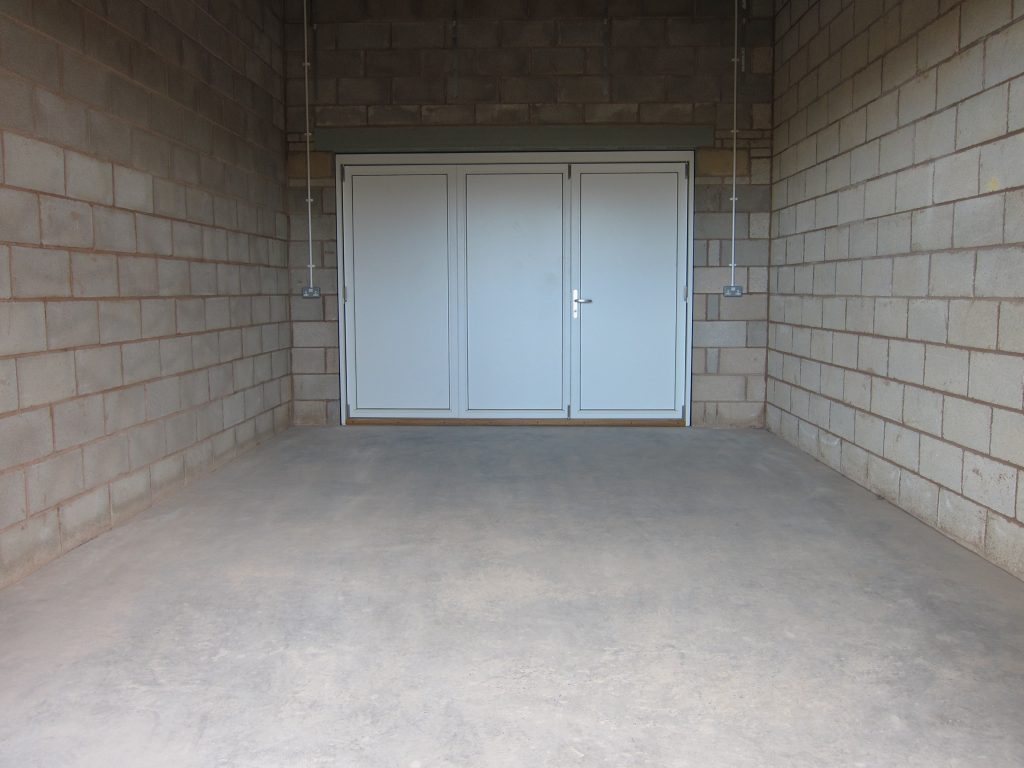

Three-leaf bifold door installed between the single Garage (pictured) and the end of the Workshop

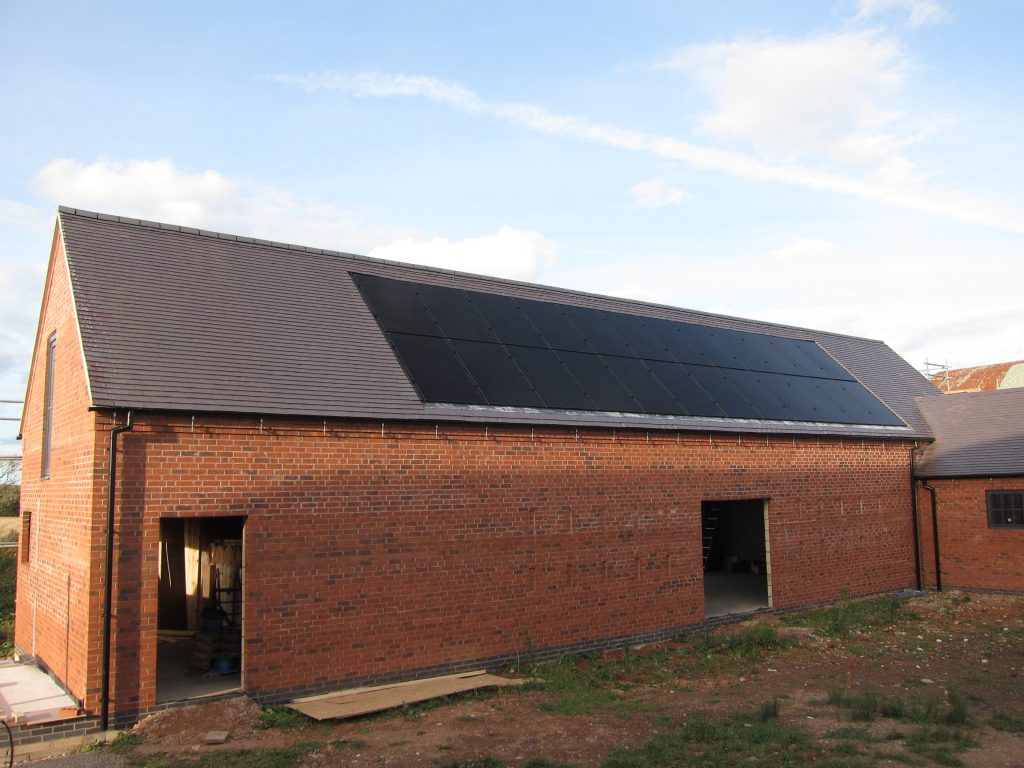

Roofing now completed over the Garages, following the installation of the Ridge Tiles with a dry-fix ventilated ridge kit made by Timloc
