Week 38, Day 5

Week 38, Day 5:

  • More progress with the zinc roofing, nearly completing the south roof and starting to install the underlay on the north (curved) roof
  • More electrical second-fix – computer network outlets and light switches on the second floor
  • More plastering, getting the bathrooms ready for tiling (and better visibility of the plaster in the stairwell now the internal scaffolding has been removed)
Week 38, Day 5

Week 38, Day 5

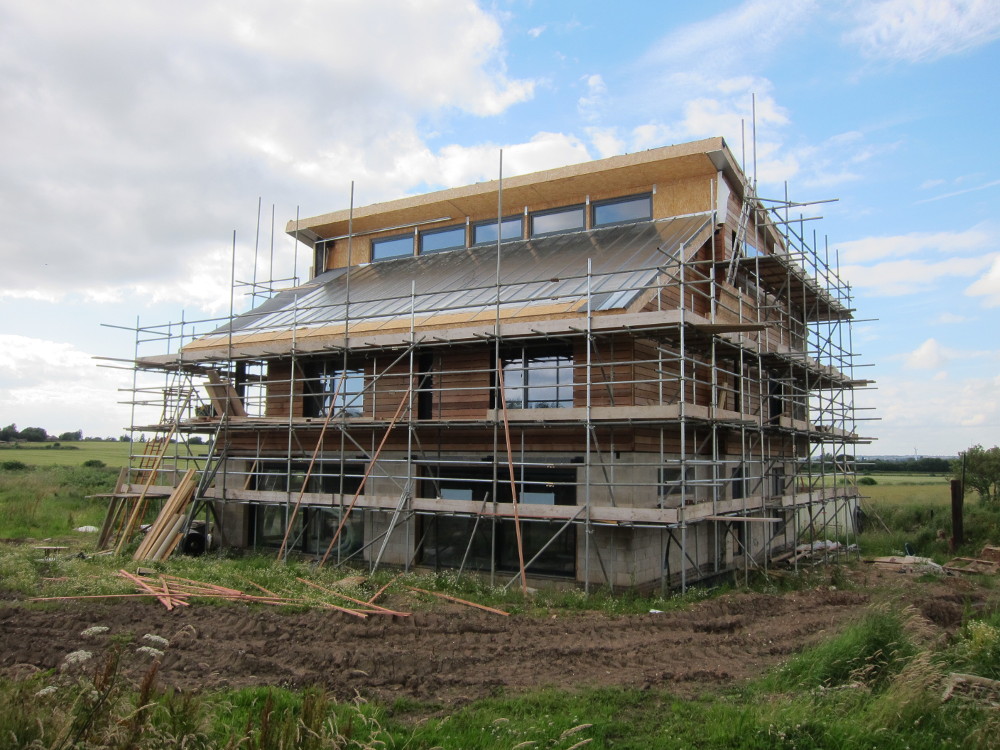

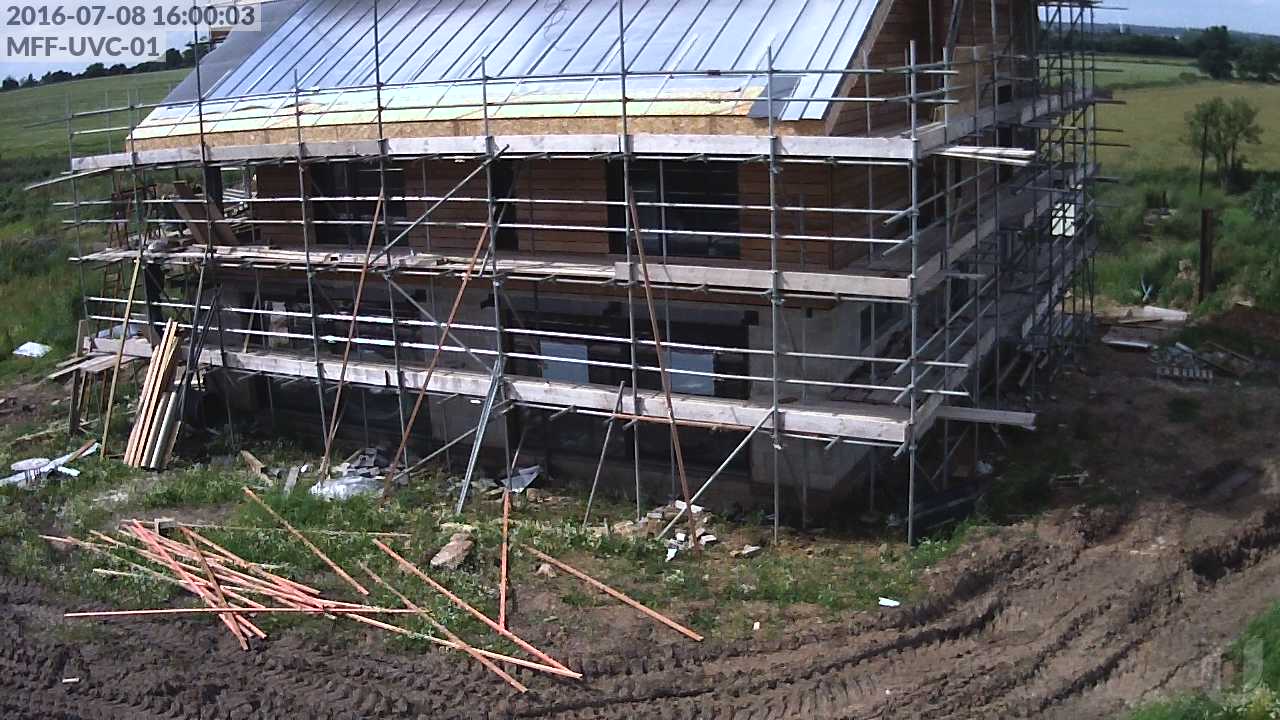

Wider view from main camera location

Wider view from main camera location

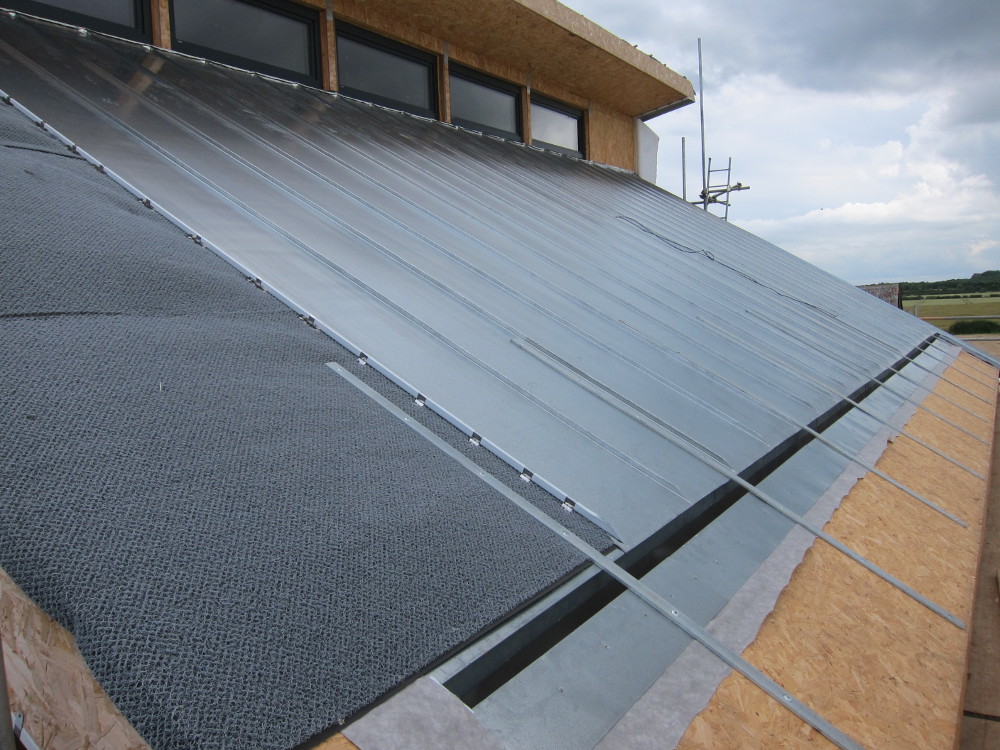

Closer view of zinc on south roof

Closer view of zinc on south roof

Structured roofing underlay on vertical section of north roof

Structured roofing underlay on vertical section of north roof

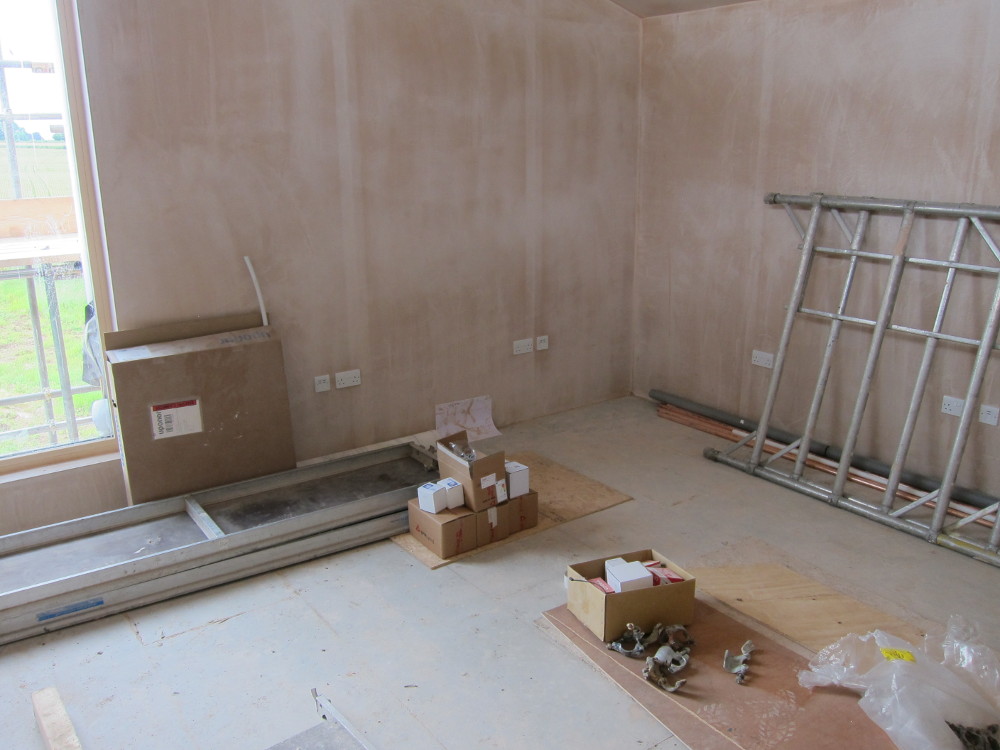

Computer network sockets adjacent to power sockets in home office

Computer network sockets adjacent to power sockets in home office

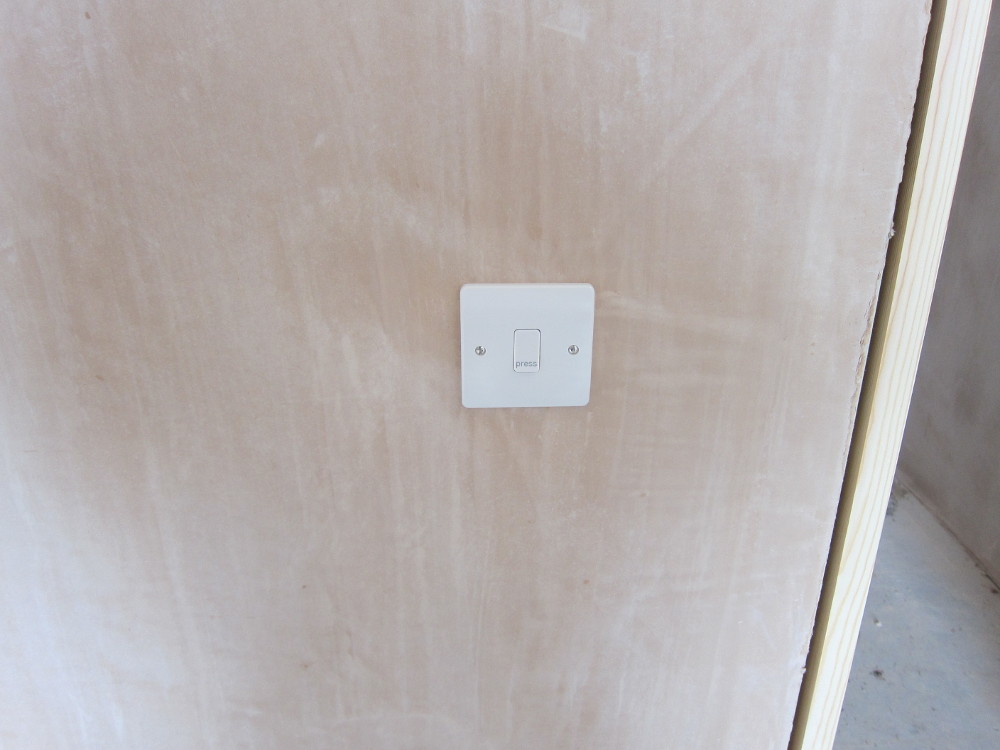

Momentary-action ("Press") light switch in home office

Momentary-action (“Press”) light switch in home office

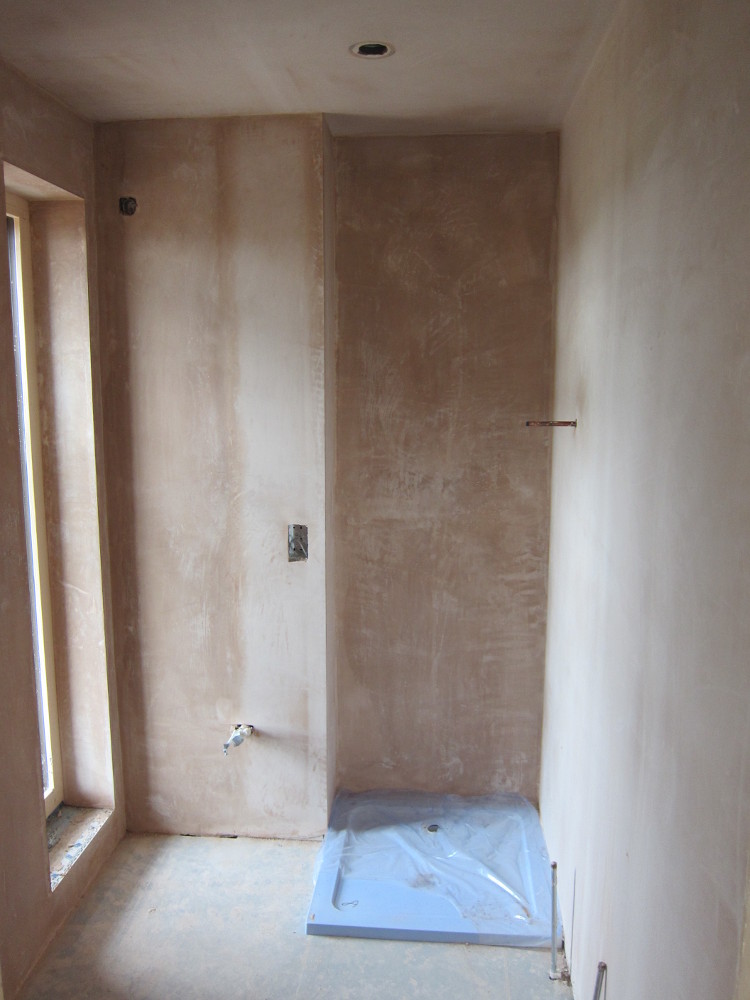

Completed plastering in En-Suite to Bedroom 3

Completed plastering in En-Suite to Bedroom 3

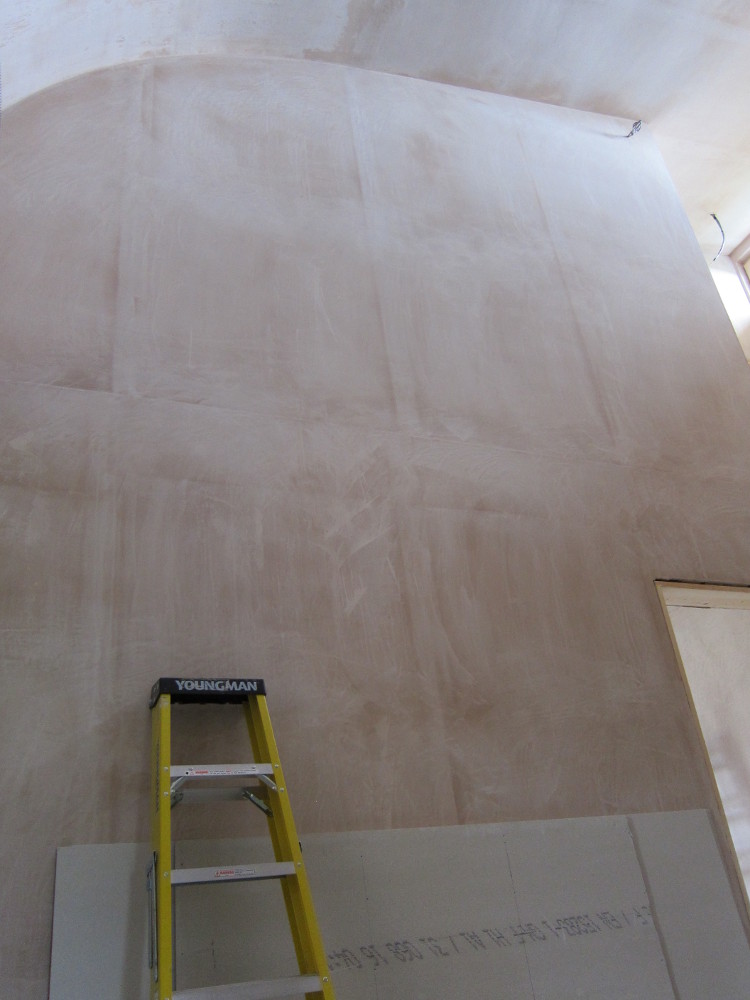

More-than-double-height space over stairwell

More-than-double-height space over stairwell
