Week 39, Day 1:
- Lots more progress on the zinc roofing, with the lower (vertical) third of the north (curved) roof completed in one day
- Some more work on the second-fix plumbing, in preparation for the tiling

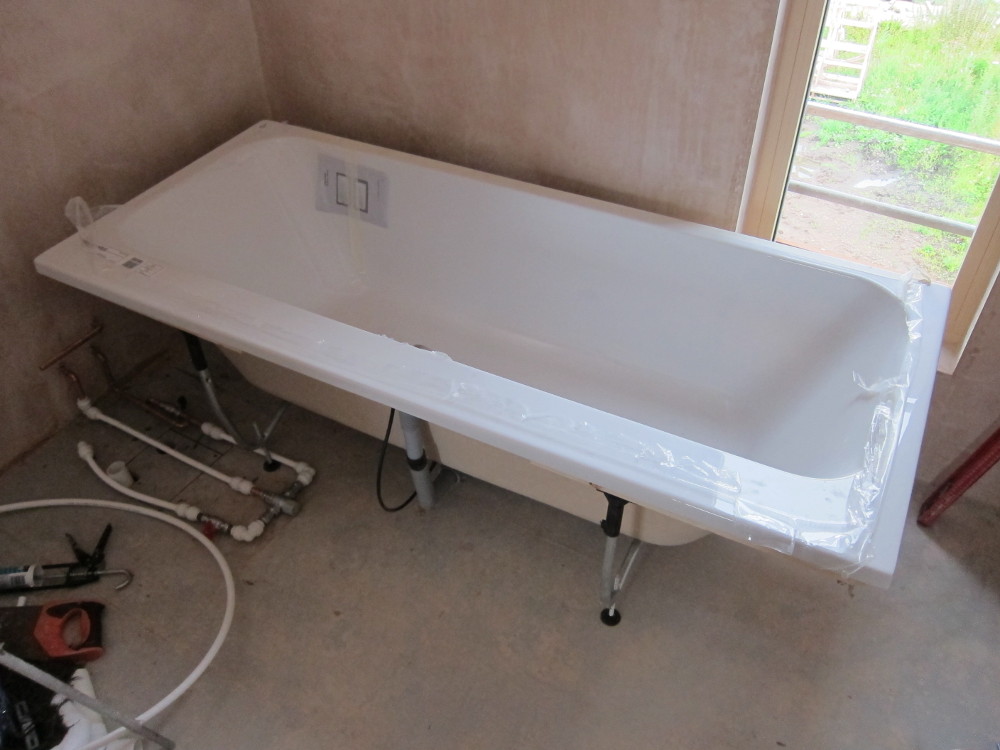

- The shower trays are already installed
- The baths (x3) and some of the basins arrived today
- Good further progress on the plastering

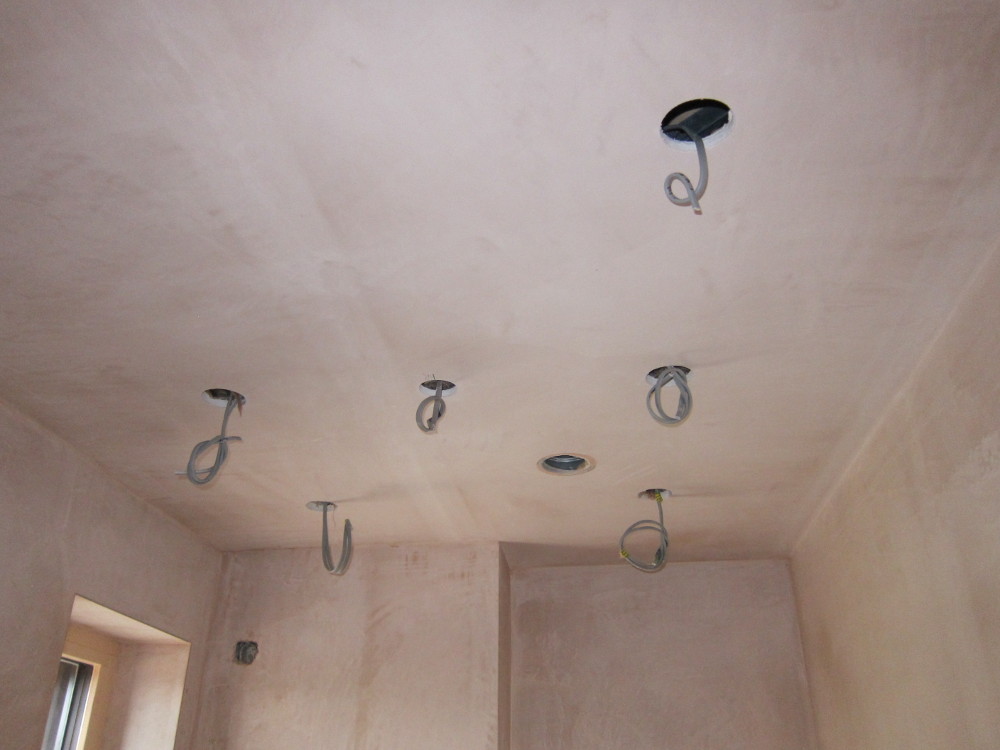

- Further progress on the second-fix electrical – more sockets and the first of the down-lighter cut-outs

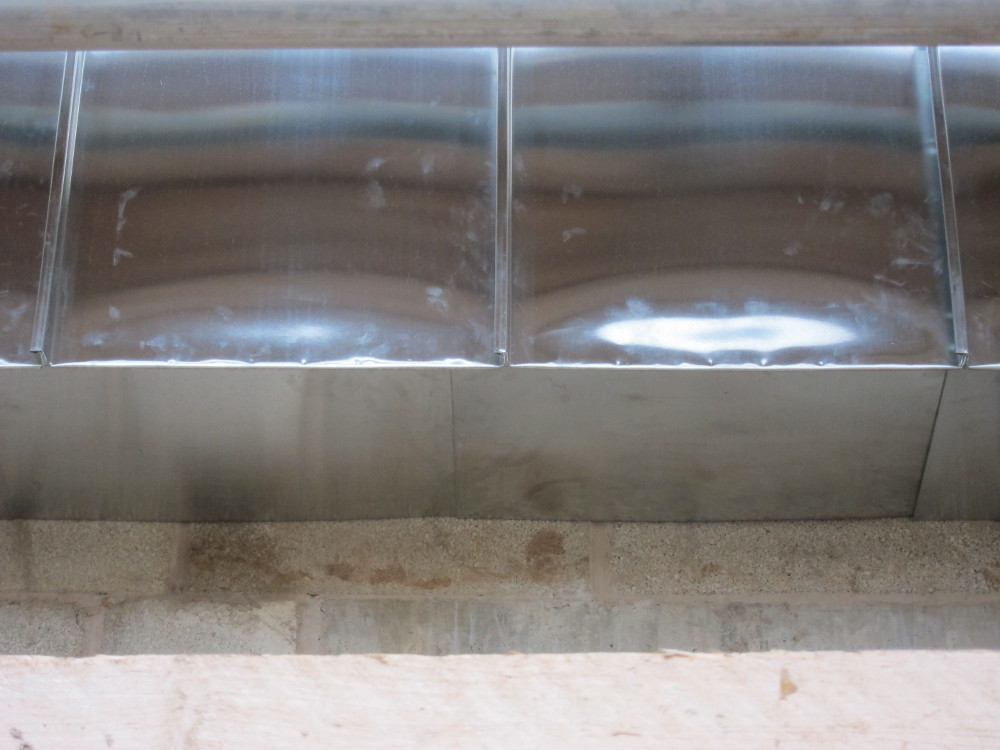

First few sections of zinc on the vertical face of the north roof installed by 10am, zinc panel forming machine in the foreground
The zinc panels don’t stay that shiny for long – the panels on the south roof have already gone a duller colour after the first rain shower.

No further zinc installed on the south roof but preparation for the cedar cladding around the clerestory windows
The hot water runs through a temperature regulator valve upstream of the wall-mounted mixer valve (out of shot), and the outlet from the mixer enters the bath via the “overflow”.
